How to Create Relative and Timeline Offset Workflows
Timeline settings allow you to automate the scheduling of tasks within a workflow by anchoring them to a specific date. By using relative dates and offsets, you can ensure that all associated tasks in a matter automatically adjust their due dates whenever the central anchor date changes.
Link to Video Guide: https://youtu.be/wEcC-JDzURU?si=yPUdZTvtzhgRh1Bc
Prerequisites
- You must have Admin or Workflow Manager user permissions to access and edit workflow templates.
Understanding Workflow Anchors
In Yao, a workflow is built around a single "Anchor Task". This task serves as the "Source of Truth" for the entire timeline.
- Single Anchor Rule: You can only have one anchor task per workflow.
- Branching Workflows: If your process requires multiple anchor dates (for example, both a "Start Date" and a "Court Hearing Date" which move independently), you should create additional separate workflows and branch them together.
Setting an Anchor Task
The anchor task is the fixed point which determines the dates for all other tasks in the sequence.
1. Navigate to the Workflows tab on the left-hand sidebar.
2. Select an existing workflow to edit or click Add to create a new one.
3. Open the task which you wish to set as the anchor by clicking the Edit (pencil) icon, or create a new task by clicking the + (plus) icon.
4. In the New Task or Edit Task modal, locate the Timeline Settings section at the bottom.

5. Tick the checkbox for Anchor Task (Source of truth for this workflow). The task will now display an anchor icon in the workflow builder.
6. Click Save.
Configuring Relative Offset Tasks
Once an anchor is established, you can set other tasks to occur a specific number of days before or after that anchor.
1. Select the task which needs a relative date and open the edit modal.
2. In the Timeline Settings section, locate the Offset days field.
3. Enter the required offset:
- To set a task after the anchor, enter a positive number (e.g., "10").
- To set a task before the anchor, enter a negative number (e.g., "-10").
4. If the task should only be scheduled on workdays, tick the Use business days only checkbox.
5. Click Save. The task will now display the offset value (e.g., +11 calendar days) in the workflow view.
Using Timeline Offsets within a Matter
When a workflow with relative dates is applied to a matter, the system synchronises the entire schedule based on the anchor task's completion date.
1. Open the specific Matter and navigate to the Tasks tab.
2. Locate the task marked with the Anchor icon.
3. Click the Calendar icon next to the anchor task to adjust its date.
4. Select a new date from the calendar picker.

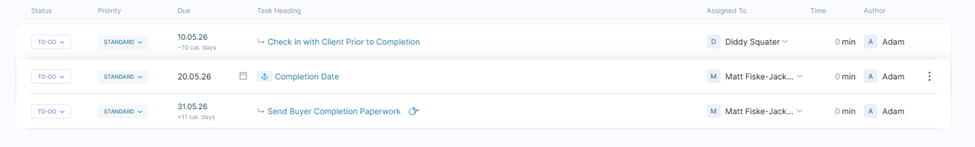

5. Observe the Due column for the other tasks in the workflow. All tasks with offsets will automatically recalculate and update their due dates based on the new anchor date.
